Now that you have your main projects table, you can use formulas to roll up the values from each of the briefs into one, high-level overview! Here are some fun ways to roll up the information:
Reference Column:

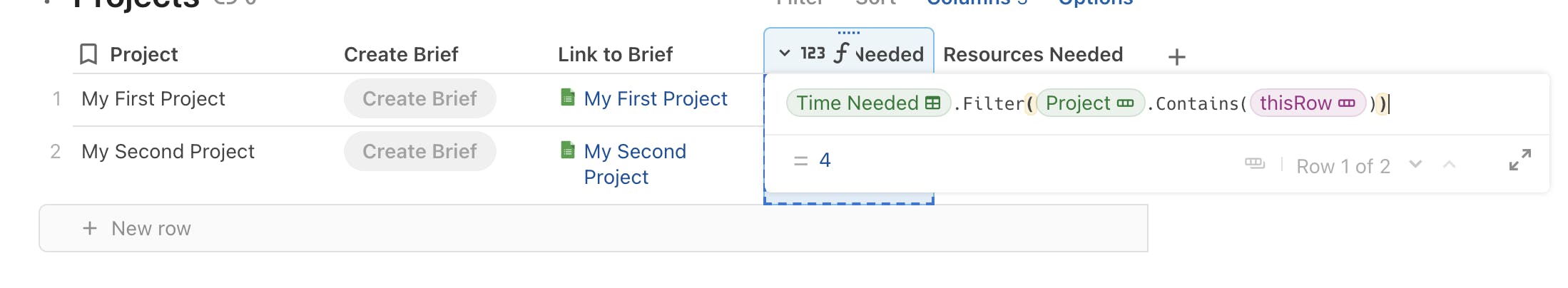

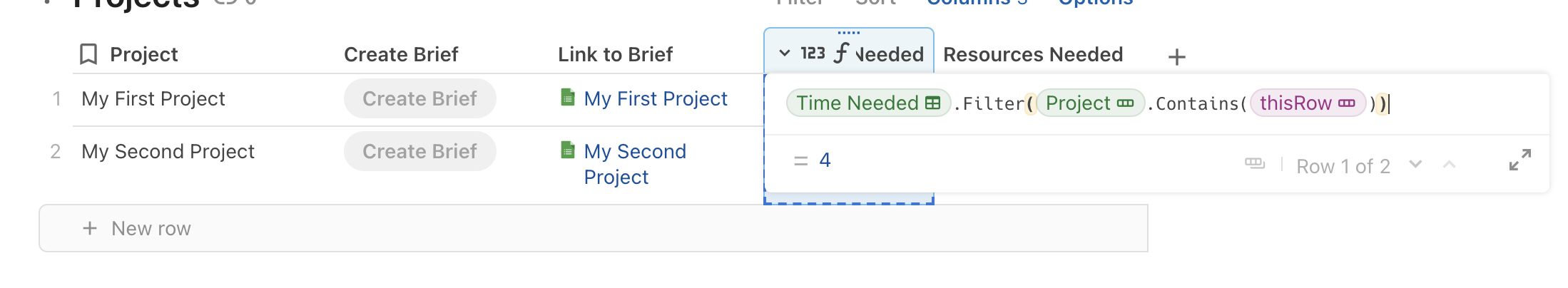

In the “Weeks Needed” column, we captured how many weeks was needed to complete a project. We can display this in the main table using a Reference column, or using the following formula:
Summary:

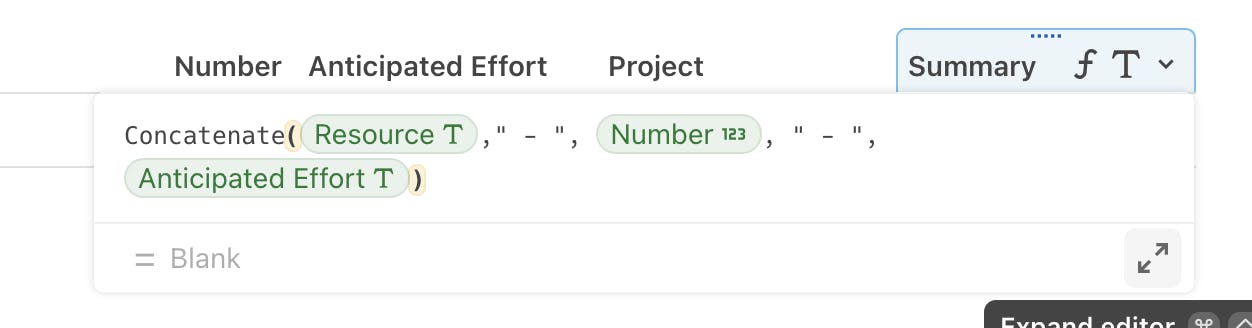

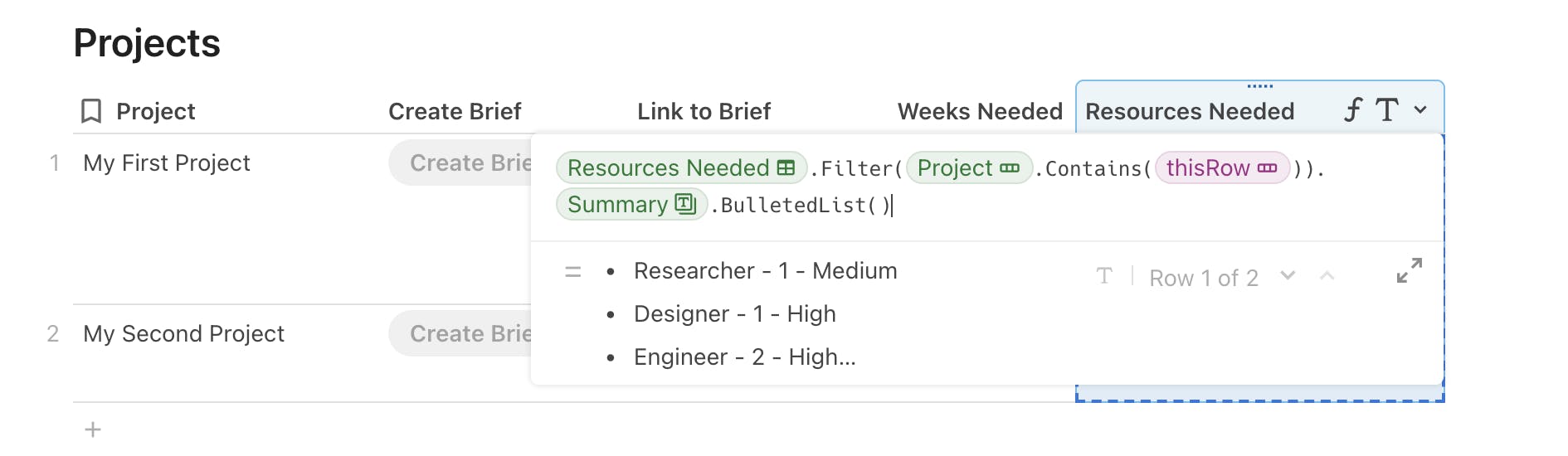

To add a summary to your main table, for example, in the “Resources Needed” column:
First, on the table, add a “Summary” column that uses the Concatenate formula to concatenate the information you want in the summary: Next, on the main table, use the following formula to display that summary: That’s all! I hope that you found these instructions helpful.
