One of the main requirements of the PAS 2035 retrofit process is a risk assessment of the works to be carried out before they start. This risk assessment determines the way the project is run (known as the Pathway). The three pathways are as follows
Path A: The simplest of retrofit projects, topping up loft insulation for example. These require Path B: Medium risk projects, where there are multiple measures being installed, they are riskier and/or the building itself is older or has particular problems. Path C: High risk projects, where there are multiple properties, they are high rise or other risks. For each path there are sets of increasingly complex requirements to ensure your project runs smoothly. Further details can be found in this document Whilst it may seem initially that retrofit projects are relatively low risk there are a number of things that can go wrong. Your house was designed to operate in a certain way, older houses had open fires and plenty of air circulating to feed them this means relatively few damp problems . Retrofitting a house typically involves removing these draughts and making the house more airtight which means moisture is retained within the house and needs to be managed correctly.
Alongside this there are other risks such as fire, poor installation or changes to historical features.

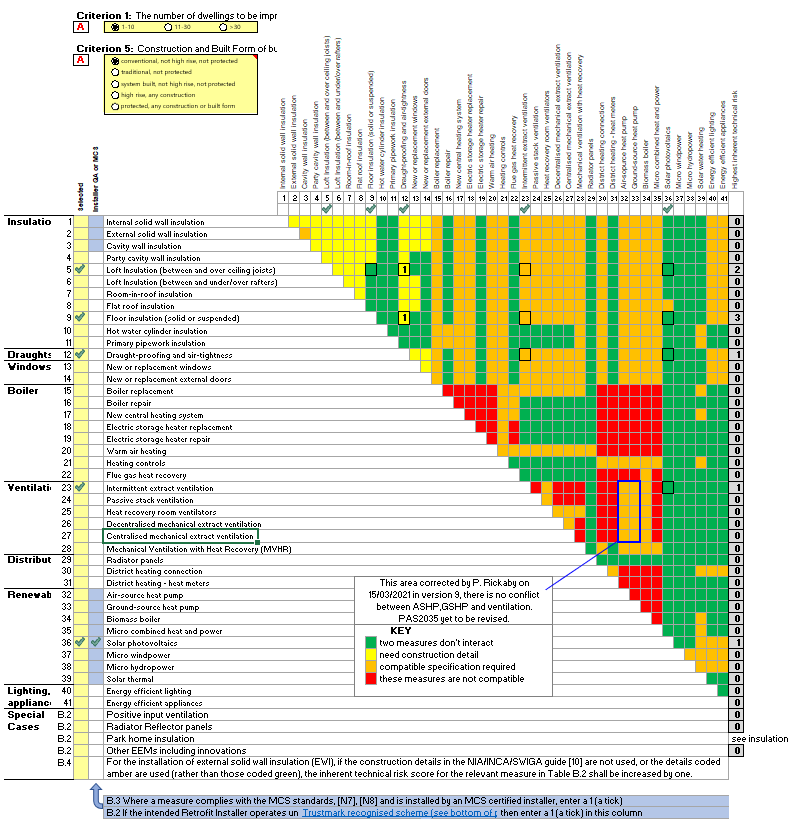

Finally there is the possibility that different improvement measures will conflict with each other and reduce effectiveness or create problems. This is shown in the matrix at the end.
Using the analysis this project is assessed as the following grade:
Number of measures per dwelling
Number of dwellings in the project
Construction and Built Form
